What Henry County Needs to Decide
For the past two weeks, we've explored why data centers are being built at an unprecedented pace and examined the potential benefits and concerns they bring to the communities that host them.
Now the focus shifts to Henry County.
In June, the Henry County Board approved a 12-month moratorium on new data center projects. The decision wasn't intended to stop development permanently. Instead, county leaders chose to pause, gather information, and determine whether Henry County's current regulations are sufficient—or whether new rules should be in place before a proposal ever reaches the County Board.
A Pause to Plan
Data centers are unlike most developments the county has considered in the past.
A new subdivision, manufacturing facility, or retail business each presents its own challenges. But modern data centers bring unique questions involving electricity, water, technology infrastructure, emergency response, and long-term land use.
Rather than waiting until an application arrives, county officials have opted to establish expectations in advance.
The goal is simple: create a fair, transparent process that protects the public while giving developers a clear understanding of the county's requirements.
Where Should They Be Allowed?
One of the first decisions the county may need to make is where data centers could be built. Space needs range from 15-30 acres for a small facility, 30-150 acres for an average data center, and up to 150-500+ acres for “hyperscale” centers.
Throughout the Henry County moratorium, the board will be considering questions like:
Should they be limited to industrially zoned property?
Should they be located near existing electrical, utility, or stormwater infrastructure?
Should productive farmland receive additional protections?
Should minimum setbacks be required from homes, schools, parks, or other sensitive areas? Will any additional landscaping/ screening be required?
Are safeguards in place to protect farmland and our rural character?
The answers will shape not only whether a project is approved, but where one could realistically be proposed.
How Much Power Is Too Much?
Modern data centers consume large amounts of power, and future facilities are expected to require even more as technology needs continues to expand.
Issues that are not properly addressed upfront can cause increased electricity bills:
need for new substations, transmission lines, or equipment
higher capacity requirements
stranded (abandoned) projects
increased wholesale prices due to increased demand
local grid updates
Addressing these issues prior to approval may involve:
an infrastructure payment agreement
a utility cost-impact study
separate utility rates so the data center pays its fair share (also known as a separate large-load rate treatment)
exit and stranded cost protections
agreed-upon expansion triggers
public reporting and accountability measures
third-party regulator reviews
While utilities ultimately determine whether power can be supplied, the county may require developers to document those plans before a project moves forward.
How Will Water Be Managed?
Not every data center uses the same cooling technology. Some rely primarily on outside air. Others use water-based cooling systems. Still others use hybrid designs that reduce water consumption while maintaining efficient operation. Water consumption ranges from as much as 5 million gallons daily to nearly zero, depending on the cooling system and the size of the facility.
Before considering a project, the county may want developers to identify:
Acceptable cooling systems
Estimated daily water use
The source of the water
Potential impacts on nearby water systems
Plans for drought conditions
Wastewater management
Maximum annual withdrawal and consumption caps
Water usage and monitoring measures
What About Noise?
Unlike factories, data centers typically don't produce smoke or heavy truck traffic. They do, however, operate 24 hours a day. Cooling equipment, transformers, ventilation systems, and backup generators all create sound.
Many communities establish measurable noise standards instead of relying on subjective descriptions like "too loud."
Possible standards could address:
Maximum daytime noise
Maximum nighttime noise
Property-line measurements
Generator testing schedules
Required sound barriers or landscaping
Quieter equipment
Noise monitoring, complaint, and response plans
Clear standards provide certainty for both residents and developers.
Emergency Preparedness
Data centers contain sophisticated electrical equipment, backup power systems, batteries, and fire suppression systems.
Although these facilities are designed with multiple layers of safety, local emergency responders still need to have the tools and training to respond appropriately to potential emergencies.
County officials may ask:
What specialized training would responders need?
Would additional equipment be necessary?
How would emergency access be maintained?
What information should fire departments receive before construction?
These discussions often occur long before a building permit is issued.
Roads and Infrastructure
A project of this size could affect roads, utilities, and other public infrastructure. Construction may require heavy equipment and frequent deliveries. Electrical service may require upgrades. Fiber-optic connections may need expansion.
One important question is who pays for those improvements. Many communities negotiate development agreements that clearly assign responsibility before construction begins.
County officials may formalize expectations regarding:
road repairs for wear and tear caused by construction traffic
upgrades to roads, bridges, and intersections
traffic control, signage, and safety measures
dust control and cleanup
construction hours
Air Pollution
Data centers rely on backup generators to keep critical systems running during outages. When these generators run or are tested, they emit pollution, including:
nitrogen oxides
particulate matter
carbon monoxide
volatile organic compounds (VOCs)
carbon dioxide
other toxins including formaldehyde, benzene, and others
Limiting those pollutants or outlining expectations requires policies outlining:
generator testing schedules
generator maintenance runs
fuel used in generators
location relative to prevailing winds and nearby homes, schools, businesses
stack height and dispersion modeling
Data center generators are regulated as stationery engines under the Clean Air Act.
Weighing the Choice
Supporters often point to the economic impact of data centers, while opponents often question whether those benefits justify the project's size and infrastructure needs.
Rather than relying on estimates or assumptions, the moratorium allows Henry County the opportunity to evaluate measurable information, including:
Expected property tax revenue
Potential tax incentives
Construction investment
Temporary construction jobs
Permanent employment
Local purchasing commitments
Infrastructure contributions
Long-term maintenance obligations
Looking beyond the headline investment number allows decision-makers to understand a project's overall impact on the community.

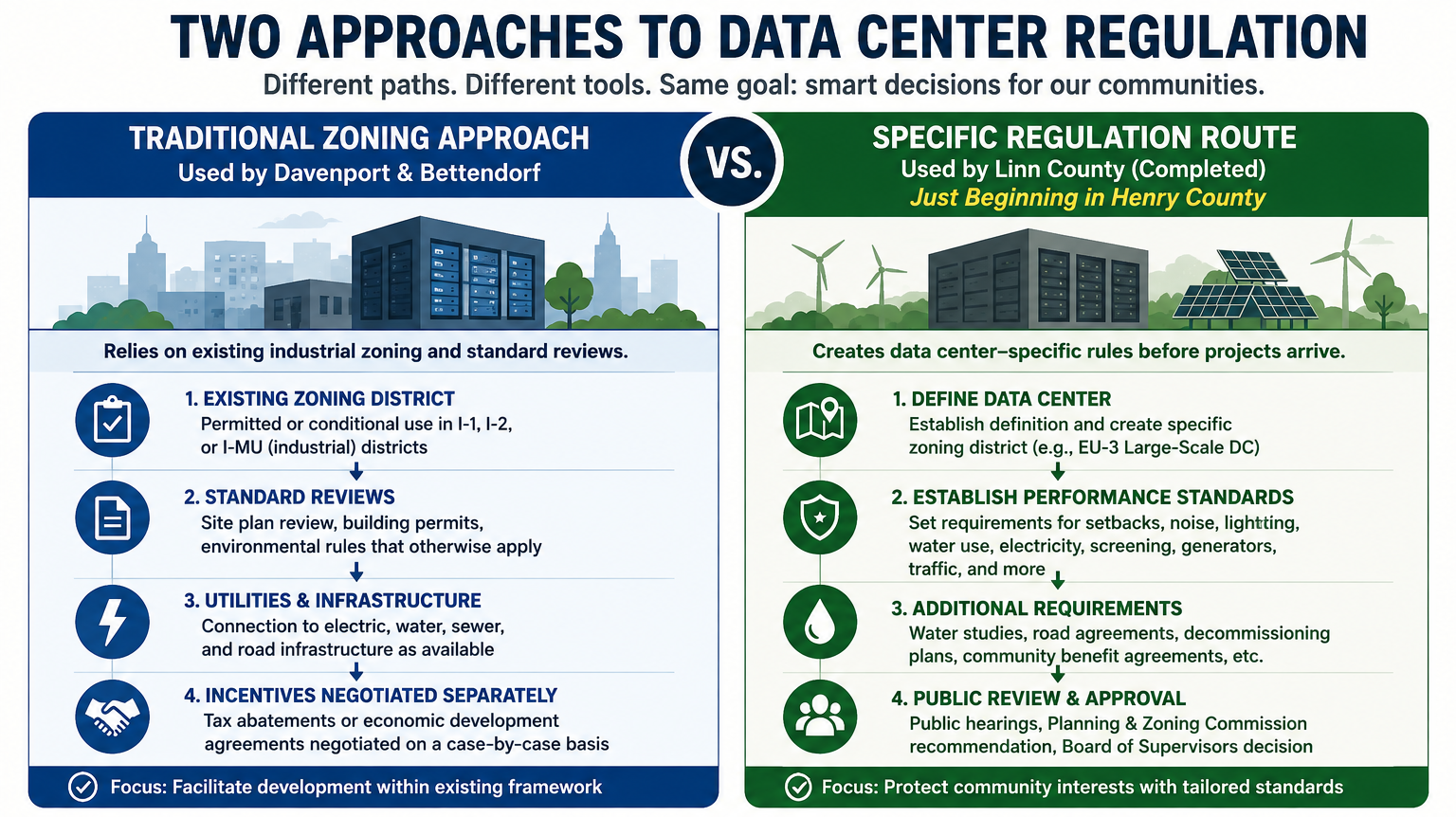

Should Henry County Create New Rules?
One of the biggest questions during the moratorium is whether the county's existing zoning regulations are enough.
Many communities have concluded that data centers deserve their own standards because of their unique infrastructure needs.
A future ordinance could address issues such as:
Appropriate zoning districts
Minimum lot size
Building height
Setbacks
Landscaping and screening
Noise limits
Water reporting
Utility documentation
Emergency response planning
Road-use agreements
Environmental requirements
Financial guarantees
Decommissioning plans if a facility eventually closes
The purpose of those standards wouldn't necessarily be to encourage or discourage development. Their purpose would be to ensure every proposal is evaluated using clear, consistent, and transparent criteria.
Looking Beyond One Project
The decisions Henry County makes during this moratorium could shape how the county evaluates technology-related development for decades.
Strong regulations provide clarity for residents, developers, and elected officials alike. Poorly defined regulations can create uncertainty for everyone involved.
The coming months give Henry County an opportunity to ask difficult questions before difficult decisions have to be made.
Next in the series: How would a data center proposal actually move from concept to construction? In the final installment, we'll walk through the decision-making process, the roles of local, state, and utility partners, and how residents can participate as plans take shape.
Sources:
Illinois Department of Commerce & Economic Opportunity (DCEO)
U.S. Department of Energy – Powering America's AI Future: Data Center Resource Hub
JCE Co-op. Powering Growth, Keeping Members First. HI-LINES, August 2026.
JLL Research, North American Data Center Report 2024
Cushman & Wakefield- Data Center Landscape 2024
Uptime Institute- Data Center Industry Survey 2024
